The Maintenance Queue Is the Real Drone Bottleneck

Small defects, uncertain parts, approvals, and troubleshooting time can remove more capacity than major scheduled maintenance.

Downtime accumulates in the waiting states between defect, diagnosis, part, approval, and release.

Drone fleets rarely stop because every aircraft reaches a major overhaul at once. Capacity erodes through smaller queues: a damaged connector waits for inspection, a battery fault waits for disposition, a software issue waits for reproduction, or a replacement part waits for approval. The repair task may be short; the elapsed downtime is not.

Map maintenance as a flow. Record defect time, triage, technical owner, needed evidence, parts status, repair, verification, and release. Measure queue age and reason, not only labor hours. The longest wait often points to an information or authority bottleneck rather than a technician shortage.

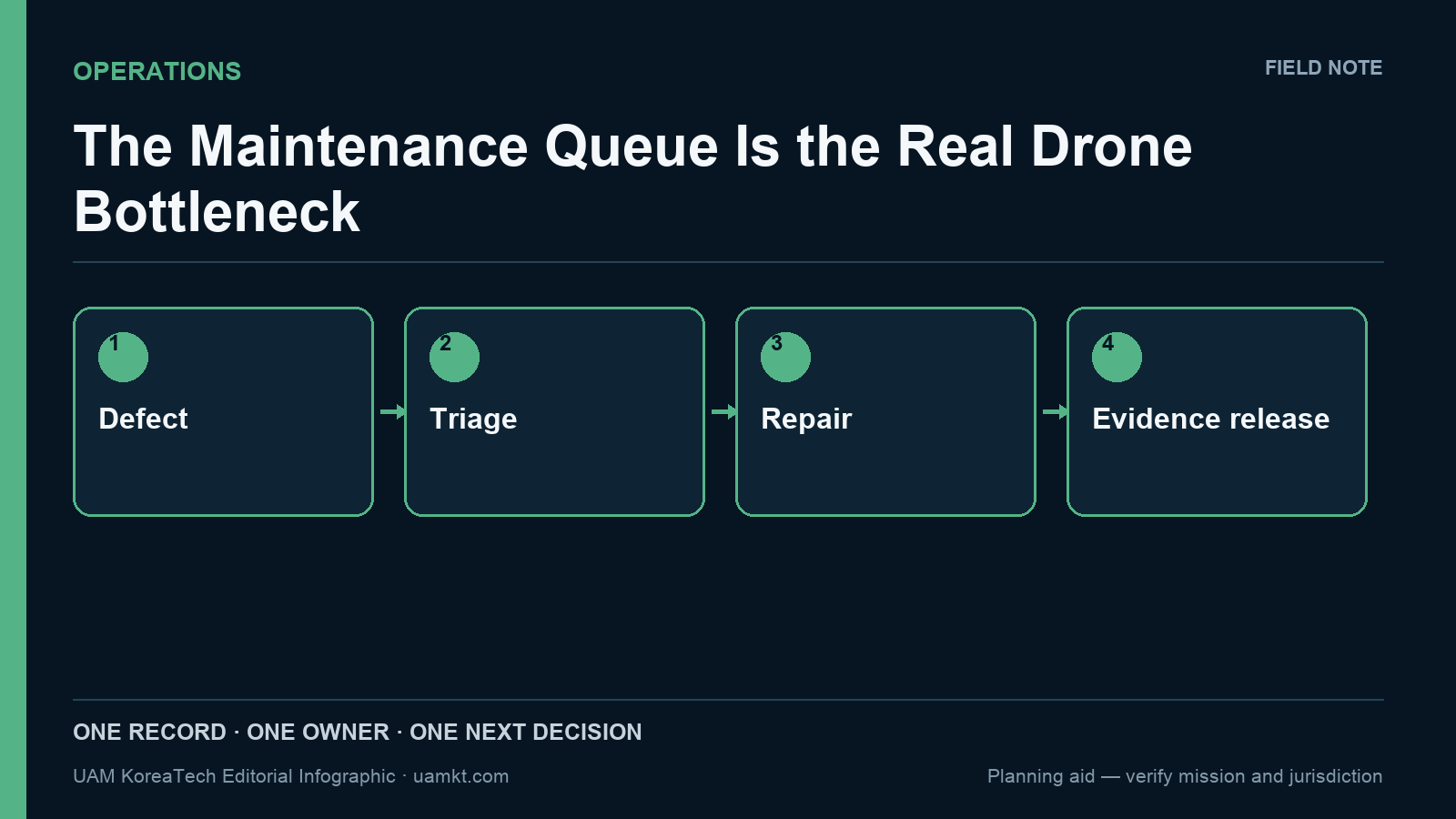

The Maintenance Queue Is the Real Drone Bottleneck — editorial decision-flow infographic

Editorial infographic: Defect → Triage → Repair → Evidence release. The diagram is a planning aid, not a certification or regulatory determination.

A four-part decision lens

  1. Open one traceable defect record. Make the condition visible in the same record used for the decision.
  2. Classify safety and capacity impact. Assign an owner and state what evidence will count as completion.
  3. Expose waiting reason and owner. Keep assumptions separate from observed or approved facts.
  4. Verify repair against baseline. Test the exception path, not only the preferred operating case.
  5. Release with evidence and feedback. Review whether the control changed the next real decision.

What this looks like in the field

Three aircraft await the same inexpensive motor component. Purchasing assumes the maintenance team has alternatives; maintenance assumes procurement is ordering. A queue dashboard with part number, substitute decision, owner, and due date turns an invisible coordination gap into a solvable constraint.

The management value lies in the boundary between one state and the next. A team must be able to see why an item moved from observation to action, from action to restriction, or from restriction to closure. If the transition has no named authority and no retained basis, the label is only decoration.

Governance before automation

Do not optimize queue time by weakening inspection or release authority. Separate active work from waiting, and analyze repeat defects by configuration and use. Spares decisions should use observed demand and lead time, not a single dramatic failure.

Begin automation with an exception map rather than a feature list. Identify what may proceed normally, what requires review, what must stop, and which person can release it. Software can then surface deadlines and missing evidence without pretending to make the consequential judgment.

The practical test

Select a closed case and remove the people who remember it from the review. Ask a new reader to reproduce the sequence and identify the closure evidence. Any answer that begins with “I think” identifies a field, timestamp, or approval trail that the process failed to preserve.

Put it to work this week

Choose the most recent exception in this topic. Write its starting condition, decision clock, owner, evidence requirement, and closure rule on one page. Test the page with a second person and change the one line that creates the longest argument.

For this topic, use “Open one traceable defect record” as the opening prompt and “Release with evidence and feedback” as the closure check. Keep both the original and revised record so the team can see whether the intervention reduced ambiguity rather than merely changing vocabulary.

The fastest repair process is often the one that removes uncertainty about who must make the next decision.

For the wider workflow, see the related Operations field note and the UAM KoreaTech books and workbooks.

Source and scope note

This column adapts a decision framework from the Drone Fleet Control Room, TCO, and Compliance Evidence Pack workbooks. It is educational and vendor-neutral. It does not replace site-specific safety assessment, procurement law, aviation authorization, technical instructions, or professional advice. Useful primary starting points include:

Tags
drone maintenancefleet bottleneckUAS operationsspares
More in Operations
Reviewed insight feed

Follow evidence-reviewed field notes.

Subscribe to the RSS feed for reviewed articles on drone operations, bird-strike risk, CBRN readiness, and aerospace ESG. We do not collect an email address until a verified mailing service is available.
